Commercial / Critical Power Service

UPS Maintenance andService Australia

ScopeSingle and three phase
BrandsAPC, Eaton, Vertiv, Socomec, PowerShield
MeasuredImpedance, thermal, transfer, load
OutputA written report, not a tick sheet

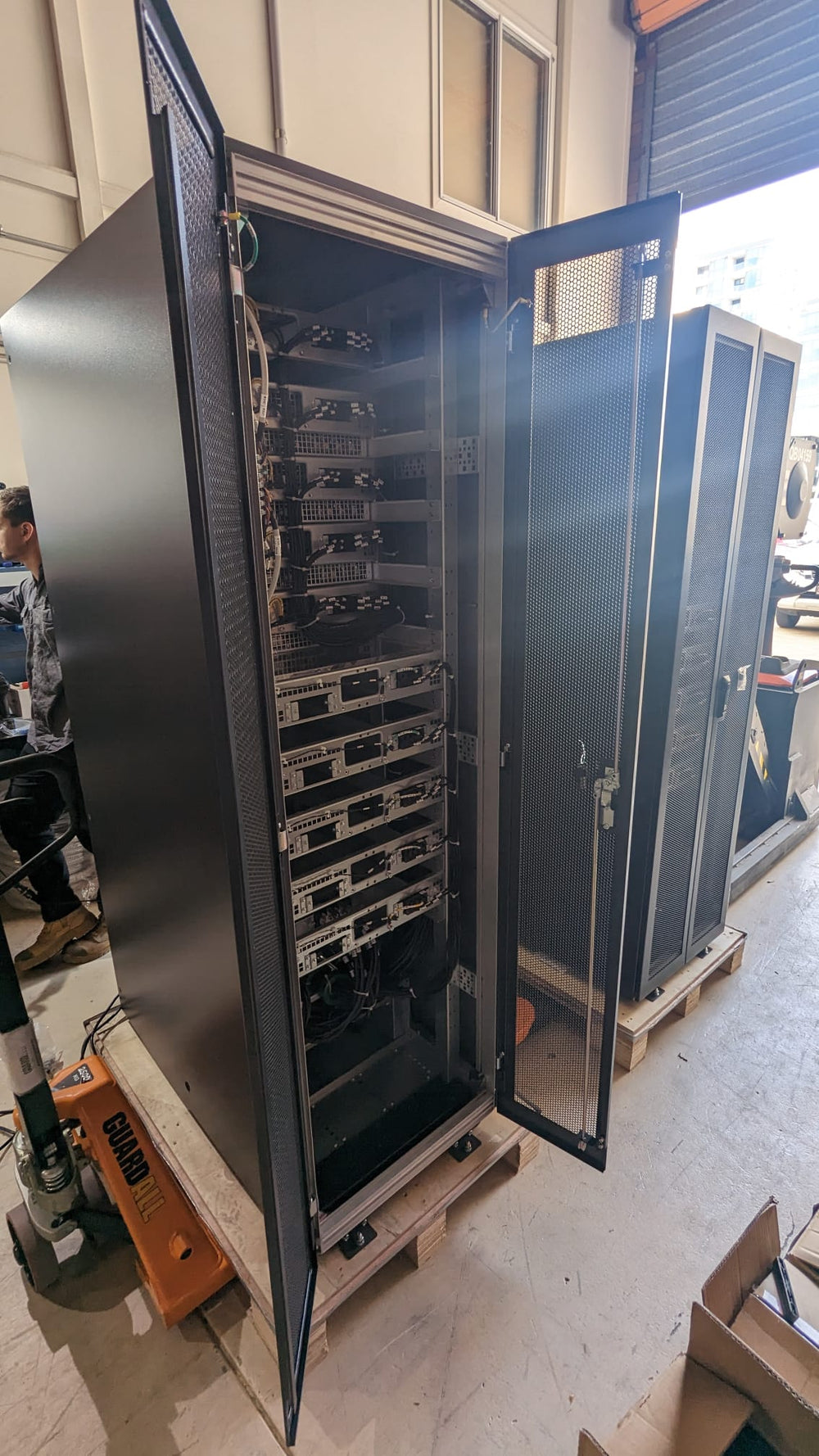

Vertiv Liebert EXM three phase UPS and battery cabinets in an Australian plant room under a maintenance agreement

Preventative servicing / Battery testing / Fault response

Most UPS service pages tell you that maintenance matters. This one tells you what we measure, what the reading has to be, and what happens to your load while we are in the cabinet.

Book a service visit →

Direct answer

An uninterruptible power supply service visit should produce four recorded measurements: battery internal impedance compared against the installation baseline, a thermal scan of every current-carrying termination, a verified transfer to and from bypass, and the alarm and event log downloaded off the unit. A visit that produces only a signed checklist has told you nothing you can act on.

Indigi Power and Cooling provides UPS maintenance and service across Australia for single phase and three phase systems from APC, Eaton, Vertiv Liebert, Socomec and PowerShield, including equipment we did not supply. Call 1800 046 344 or email sales@indigipc.com.au. Plan levels and pricing are published on our UPS maintenance plans page.

The question nobody answers

What happens to your loadwhile we are in the cabinet

This is the real reason UPS maintenance gets deferred. Not cost. Nobody wants to be the person who booked the service that dropped the data hall.

The honest answer depends on one piece of hardware: whether your installation has a maintenance bypass. With an external maintenance bypass panel, or an internal wrap-around bypass on larger frames, the load can be transferred to raw mains and the UPS fully isolated. The unit is then dead, the cabinet is safe to open, and the work happens with your equipment still running. No shutdown window, no after-hours premium, no risk to the load beyond the few seconds of the transfer itself.

Without a maintenance bypass, the choice is narrower and we will say so before quoting. Either the UPS stays energised and we limit the visit to what can be done safely on a live unit, which means battery testing, thermal imaging, log download and filter work but no internal component access, or you accept a shutdown window. On a single phase rack unit that window is minutes. On a three phase system feeding a hospital or a trading floor it is a planned event with a written switching sequence, agreed in advance, usually out of hours.

The third option is to fix the underlying problem. A retrofitted maintenance bypass switch turns every future service visit from a negotiation into a routine booking, and it is almost always cheaper than the cumulative cost of after-hours shutdown windows over the life of the UPS. If your system was installed without one, that is the single most useful thing we can recommend.

Whichever applies, the switching is done by our own licensed electricians under a written sequence, and the sequence is agreed with your site before the technician arrives. We do not improvise switching on critical plant.

Main switchboards and underfloor cable management in a commercial switchroom where a UPS maintenance bypass is switched

Where the bypass lives

Whether your switchroom has a working maintenance bypass decides what a service visit can safely cover, and whether you need a shutdown window at all. It is the first thing we check.

On every visit

What an uninterruptible power supplyservice visit actually measures

Three of these produce a number that goes into a trend. The rest produce a pass, a fail, or a defect with a photograph attached. Anything that cannot be recorded is not a test, it is a look.

Table: UPS maintenance and service procedures, what each one records, and what triggers action
Procedure What it records What triggers action
Battery internal impedance An ohmic value per block or cell, compared against the installation baseline and against the previous visit A rising trend across visits, or one block diverging from the string. Impedance flags the suspect block; a capacity test confirms it
Battery capacity or discharge test Delivered capacity as a percentage of the nameplate rating Below 80 per cent of rated capacity the string is at end of life under IEEE 1188 for VRLA and IEEE 450 for vented cells. This is the definitive measure, not impedance
Thermal imaging of terminations A temperature per joint across input, output, DC link, battery interconnects and the bypass path Any joint running hot relative to its neighbours at the same current. A loose or corroded termination shows here long before it fails
Transfer and bypass test Confirmed transfer to battery, back to mains, and to and from static and maintenance bypass A failed or slow transfer, or a bypass that does not engage. A UPS that cannot transfer is not protecting anything
Alarm and event log download The unit's own record of every event since the last visit Repeated transfers, input voltage excursions, over-temperature events or cleared faults nobody reported. This is where the site tells you what it has been doing
Capacitor condition Age against manufacturer design life, plus visual and thermal condition of DC bus and AC filter capacitors Bulging, venting, leakage, or design life reached. Electrolytic capacitor life is temperature driven and a hot plant room shortens it sharply
Fan and airflow Fan operation, bearing noise, filter condition, intake and exhaust temperatures A failed or noisy fan, or restricted airflow. Cooling failure is what turns a capacitor problem into an outage
Torque check on terminations Confirmation that power connections are at the manufacturer's specified torque Any joint found loose. Recorded, because thermal cycling loosens connections over years and this is the cheapest fault to prevent
Firmware and settings Installed firmware revision, alarm thresholds, voltage and frequency set points, battery parameters A known firmware defect, or set points that do not match the installation. Replaced batteries of a different type need the charge parameters changed and this is routinely missed
Environment Plant room and battery room ambient temperature, ventilation, cleanliness, clearances Battery ambient outside 20 to 25 degrees Celsius, blocked ventilation, or clearances that make the next visit unsafe

Battery replacement itself is quoted separately rather than bundled into a visit. See battery maintenance and replacement.

Two different tests, one name

Load bank testingis not a battery discharge test

Almost every UPS service page in Australia lists "load testing" as an inclusion. Two quite different procedures hide behind that phrase and they answer different questions.

A battery discharge test runs the UPS on battery while it carries your actual load, and measures how long it holds and what the string voltage does on the way down. It needs no extra equipment, it can be done on a routine visit, and it tells you what runtime you really have today rather than what the original design claimed. Its limitation is that it only tests at whatever load the site happens to be drawing, and it leaves you with a partly discharged battery for several hours afterwards, which is the riskiest window a UPS has.

A resistive load bank test connects a dedicated artificial load and takes the UPS up through defined steps, typically to full rated output. It proves the inverter, the rectifier, the cooling and the battery at the rating on the nameplate, not just at today's draw. It requires hired equipment, cabling, somewhere to dump the heat, and the load transferred to bypass or to a second source first. It is the test that belongs at commissioning, after a major repair, after a battery replacement, and on an annual witness test where a hospital, data centre or government site has to demonstrate capacity to an auditor.

Which you need is a straightforward question of what you are trying to prove. If you want to know whether your runtime is still real, the discharge test is enough and it is included on scheduled visits. If you have to evidence rated capacity to somebody else, or you have just changed something significant, it is a load bank and it is quoted as its own job. We will tell you which one your situation calls for rather than selling the larger one by default.

One practical note that matters more than either test: run a discharge test too often and you shorten the battery. Every deep cycle costs a VRLA string some of its life. Annual is sensible. Quarterly is not, and a provider proposing it is either not thinking or is selling batteries.

Scheduling

How often a UPS needs servicing,and why the answer changes in Queensland

Capacity drives the base interval. Where the equipment physically sits drives the adjustment, and that second half is missing from every competitor page we checked.

Table: Recommended UPS service frequency by system size and operating environment
System Base interval Battery check Adjust shorter when
Under 3 kVA, single rack or comms cupboard Annual inspection Every 12 months The cupboard has no dedicated cooling, which is most of them
3 to 20 kVA, server room or small plant Every 6 to 12 months Every 6 months Battery ambient regularly exceeds 25 degrees Celsius
20 kVA and above, three phase Every 6 months, quarterly on critical sites Every 6 months with impedance trended The site is N, not N+1, so a single failure is an outage
Data centre, hospital, emergency services Quarterly, or to the availability framework the site is held to Quarterly impedance, annual capacity An audit, tier certification or accreditation requires evidence

Heat is the whole argument

The three to five year VRLA design life everyone quotes assumes a battery held at 20 to 25 degrees Celsius. It is a rated figure at a rated temperature, not a promise. Sustained operation above that range shortens service life substantially, and the effect compounds rather than being recovered when the room cools down again. A battery string in an unconditioned Brisbane riser, a western Queensland switchroom, or a Pilbara site hut is not going to reach five years, and the interval should reflect that instead of pretending the climate is European.

Humidity and salt, on the coast

Coastal sites from Cairns to Wollongong put chloride into the air that gets into terminations and PCB edge connectors. It shows up as creeping contact resistance, which is exactly what thermal imaging catches and a visual inspection does not. On coastal and near-coastal sites we scan terminations every visit rather than annually.

Dust, in mining and agriculture

Filters load faster than any schedule predicts on a mine site, a grain facility or a quarry. A UPS that overheats because its intake is blinded will trip or derate long before anything inside it has actually failed. Where dust is the governing factor the filter interval, not the electrical interval, sets the visit frequency, and sites often run a short in-house filter check between our visits.

Storm season, in the north

A summer of frequent grid disturbance means a UPS has transferred to battery far more often than its nameplate cycle budget assumed, and the event log will show it. Across the northern wet season we would rather read the log in March than discover in November that the string has been cycled a few hundred times. If your site had a bad storm run, that is a reason to bring the next visit forward, and the log is the evidence.

The parts with a clock on them

Batteries are not the onlyconsumable in a UPS

Everybody budgets for batteries. Far fewer sites budget for the two other components that have a finite life, which is why a seven year old UPS often fails for a reason nobody planned for.

3 to 5 yr
VRLA battery design life at 20 to 25 degrees Celsius. Less when hotter, and heat damage does not reverse
8 to 10 yr
Typical lithium-ion UPS battery life, with better heat tolerance and a BMS that reports its own state
Design life
DC bus and AC filter electrolytic capacitors carry a manufacturer rated life, commonly under a decade, and it is specified at a rated temperature
Wear item
Cooling fans are bearings in a hot airstream. They are the cheapest part to replace and the most expensive to ignore

Electrolytic capacitor life is governed by temperature. The rule of thumb across the electronics industry is that useful life roughly halves for every ten degrees Celsius above the rated operating temperature, which is why the same UPS model lasts markedly longer in a conditioned data hall than in an unventilated plant room. The practical consequence is that capacitor replacement is a scheduled event driven by hours and temperature, not a repair you wait for, and the second half of a UPS lifecycle is where it becomes the governing cost.

We record capacitor and fan age against the manufacturer's stated design life on every visit and flag the replacement window ahead of it, so it lands in a maintenance budget rather than arriving as an emergency callout. On an older frame there is also a point where the economics turn and refurbishment stops making sense against replacement. We will tell you when a system has reached it, including when that means we sell you a service visit instead of a project, because finding out from a failure is considerably more expensive.

Where a manufacturer has withdrawn parts support entirely, we will say so plainly rather than quoting a maintenance agreement we cannot honour. See UPS installation and replacement for what that path looks like.

Chemistry changes the visit

Servicing a lithium UPSis a different job

"We service all chemistries" is where most providers stop. What actually changes between a VRLA string and a lithium one is worth knowing before you sign a maintenance agreement on a lithium system.

The testing method changes first. On VRLA you measure internal impedance block by block and confirm with a capacity test. On lithium the battery management system already holds state of health, cell voltage balance, temperature per module and cycle count, and the technician's job is to interrogate the BMS and read the trend out of it rather than to put a meter across terminals. Impedance testing a lithium module tells you very little. Reading its BMS tells you almost everything, provided the technician has the right tooling and access credentials for that manufacturer, which is not a given.

Firmware becomes a dependency rather than a housekeeping item. A lithium battery, its BMS and the UPS firmware are a matched set, and a mismatch after a module replacement or a firmware update can present as a fault that looks electrical and is not. This is the most common avoidable callout we see on lithium installations.

The compliance position changes too. AS/NZS 5139 covers the installation safety requirements for battery energy storage systems, and it brings location, separation, enclosure and fire considerations that a VRLA cabinet in the same room never had to satisfy. If you are retrofitting lithium into a space that was designed for VRLA, that is a design question to resolve before anybody orders equipment, not something to discover at commissioning. Battery rooms carrying either chemistry should also be considered for gas detection.

And you cannot test it the same way. There is no equivalent of a deep discharge test that a BMS will simply permit, because its job is to prevent exactly that. Proving lithium capacity means working within what the BMS allows and reading what it reports, which is a better outcome for the battery and a change of expectation for anyone used to VRLA witness testing.

Compliance

The standards that actuallyapply to UPS maintenance

Most pages in this market cite no standard at all. These are the ones that genuinely govern the work, and what each one covers.

Table: Australian and international standards relevant to UPS service and maintenance
Standard What it covers Why it matters on a service visit
AS/NZS 3000 Wiring Rules Electrical installations Governs the installation around the UPS: the supply, protection, isolation and the bypass arrangement. Any alteration we make has to comply
AS/NZS 4836 Safe working on low voltage electrical installations The basis for how our technicians work on an energised UPS, and why some tasks require the unit isolated rather than live
AS 62040 series Uninterruptible power systems, adopted from IEC 62040 AS 62040.1 for general and safety requirements, AS 62040.3 for performance and the VFD, VI and VFI topology classification that defines what your UPS is meant to do
AS/NZS 5139 Electrical installations, safety of battery systems Applies to lithium and battery energy storage installations, including location, separation and enclosure
IEEE 1188 Maintenance, testing and replacement of VRLA batteries The recommended practice behind impedance monitoring and the 80 per cent of rated capacity end of life criterion
IEEE 450 Maintenance, testing and replacement of vented lead-acid batteries The equivalent for flooded cells, still found on older large installations and in substations
AS 2293 and AS 1851 Emergency escape lighting, and routine service of fire protection systems Where a UPS backs emergency or exit lighting, the lighting has its own testing regime on its own interval. The two are frequently scheduled separately and should not be
ASHRAE TC 9.9 Thermal guidelines for data processing environments The 18 to 27 degrees Celsius equipment inlet envelope that the room has to hold, which is why UPS and cooling service belong on one schedule

Where a UPS feeds emergency lighting, pairing the two schedules saves a visit. See emergency and exit lighting testing and switchboard thermal imaging.

Multi-vendor, including equipment we did not supply

UPS brands and modelswe service

Schneider APC
Smart-UPS, Smart-UPS On-Line and UltraGalaxy VS, VL, VM and 300Symmetra PX and LX modularEasy UPS 3S and SRVBack-UPS and RBC cartridges
View range →
Eaton
5P, 5PX, 5SC and 5E9PX, 9SX, 9E and 9PXM93E, 93PS and 93PM modular9395 and 9395C large frameIndustrial, marine and FERRUPS
View range →
Vertiv Liebert
GXT5 and GXT4ITA2 and APM modularEXM, EXM2, EXS and EXLNXL and legacy pre-Vertiv LiebertPowerUPS 6000 industrial
View range →
Socomec
Netys PR and RTMasterys BC and GP4Modulys GP and XM modularDelphys industrial
View range →
PowerShield
Defender and CommanderCenturion and Centurion ProRackMount and Defence seriesAustralian designed and supported
View range →
Legacy and orphaned
Emerson and ChlorideAtlas, Hiross and BlueBoxSalicru and RielloWhere parts remain obtainable
Ask about yours →

Fault code references we publish: Eaton 9PX, APC Smart-UPS and Vertiv Liebert cooling.

The inherited system

No manuals, no service history,nobody knows the battery age

This is a very common first call. A building changes hands, an IT manager leaves, a facilities contract moves, and what is left is a three phase UPS in a locked room that nobody has opened in years.

The first visit on an undocumented system is not a routine service and we do not quote it as one. It is an audit. We identify the frame and firmware revision from the unit itself, establish battery date codes from the blocks rather than from paperwork, take a full set of baseline measurements including impedance per block, thermal scan every termination, download whatever the event log still holds, and establish whether a maintenance bypass exists and whether it works. That gives you an asset register entry and a condition report where previously you had an assumption.

The answer is sometimes unwelcome. On systems beyond parts support, or with a battery string well past end of life and a frame near the end of its economic life, the honest recommendation is replacement rather than a maintenance agreement, and we would rather say that at the audit than take a service contract on equipment that cannot be maintained. We will also tell you where a manufacturer restricts certain work to its own authorised partners, because that is a real constraint and pretending otherwise wastes your time.

Where it goes the other way, and it often does, you get a system with a known baseline, a battery replacement date you can budget for, and a documented history that starts now. That first set of impedance readings is the reference every future visit is measured against, which is why the audit is worth doing properly even if the outcome is good news.

If the UPS also sits behind a switchboard nobody has inspected, the same logic applies to the supply side. See power integrity inspection.

Regional and remote, honestly

We service regional and remote sites across Australia, and we will not claim a metro response time for them.

A fault in Mount Isa, Karratha, Katherine or Alice Springs is a travel problem before it is a technical one, and the realistic commitment is next available flight or drive, with the part in hand rather than ordered on arrival. That is why the first remote visit matters so much: a documented spares list and a known battery age let us arrive with what the job needs instead of making two trips. Mobilisation is charged per trip and we combine scheduled visits across nearby sites wherever the geography allows it, which is usually the difference between a sensible annual cost and an absurd one. For multi-site fleets we will map the run before quoting.

Questions we get asked

UPS maintenanceand service FAQs

What is UPS maintenance?

UPS maintenance is the scheduled servicing of an uninterruptible power supply and its battery string so that faults are found while the site is in a controlled state rather than during the power event the UPS was bought to survive. A proper visit measures battery internal impedance against a baseline, thermally scans every current-carrying termination, verifies transfer to and from bypass, downloads the alarm and event log, checks capacitor and fan condition against design life, and produces a written report with recorded values. It is distinct from a UPS maintenance plan, which is the commercial agreement that schedules those visits.

What is the difference between UPS service and UPS maintenance?

In practice the two words are used interchangeably, and UPS servicing is the same work under a third name. We treat all three as the same thing. Where a distinction is useful, maintenance is the planned preventative work on a schedule, and service is the broader term that also covers reactive attendance, fault diagnosis and repair after something has gone wrong. Both are covered here. The thing that actually matters is not the label but whether the visit produces recorded measurements you can trend, or just a signature.

Can you service my UPS without shutting down my equipment?

If your installation has a maintenance bypass, yes. The load transfers to raw mains, the UPS is fully isolated, and the work is done with your equipment still running. Without a maintenance bypass the choice is between a restricted live visit, which covers battery testing, thermal imaging, log download and filter work but no internal component access, or a planned shutdown window with a written switching sequence agreed in advance. We establish which applies before quoting, and if there is no bypass we will usually recommend retrofitting one, because it removes the problem permanently.

How often should a UPS be serviced in Australia?

Under 3 kVA, annually. Three to 20 kVA, every six to twelve months with a six monthly battery check. Twenty kVA and above, every six months, and quarterly on critical sites. Data centres, hospitals and emergency services usually run quarterly with annual capacity testing. Shorten the interval where battery ambient exceeds 25 degrees Celsius, where the site is coastal, where dust loads filters quickly, or where there is no redundancy so a single failure is an outage. Australian conditions matter more than the generic interval.

What does UPS battery testing involve?

Internal impedance is measured per block or cell and compared against the installation baseline and the previous visit, which identifies a failing block within a string. Impedance flags the suspect; a capacity or discharge test confirms it by measuring delivered capacity against the nameplate rating. Below 80 per cent of rated capacity the string is at end of life under IEEE 1188 for VRLA cells and IEEE 450 for vented cells. On lithium systems the method changes: the battery management system holds state of health, cell balance and cycle count, and the job is to interrogate the BMS rather than to put a meter across terminals.

What is the difference between load bank testing and a battery discharge test?

A battery discharge test runs the UPS on battery while carrying your actual load and measures how long it holds. It needs no extra equipment, fits a routine visit, and tells you what runtime you really have today. A resistive load bank test connects a dedicated artificial load and takes the UPS to its rated output, proving the inverter, rectifier, cooling and battery at nameplate rather than at today's draw. It needs hired equipment, heat rejection and the load on bypass, and it belongs at commissioning, after a major repair or battery change, and where rated capacity has to be evidenced to an auditor. Discharge testing too often shortens the battery, so annual is sensible and quarterly is not.

How do I repair my UPS?

A UPS should not be opened by site staff. Dangerous DC voltages remain present inside the cabinet after the unit is switched off and the mains is isolated, because the battery string is still connected, and the capacitors hold charge after that. What site staff can safely do is record the alarm or fault code from the display, note what the load was doing, check that intakes and filters are not blocked, and confirm the room is not over temperature. Then call someone with the right test equipment and training. We publish fault code references for Eaton 9PX and APC Smart-UPS to help identify what the unit is reporting before a technician attends.

Do you service UPS systems you did not supply?

Yes, and most of the systems we maintain were installed by someone else. We are vendor agnostic across APC and Schneider, Eaton, Vertiv Liebert, Socomec and PowerShield, and we take on legacy and orphaned equipment including Emerson, Chloride, Atlas, Hiross and BlueBox where parts remain obtainable. On an undocumented system the first visit is an audit rather than a routine service: we identify the frame and firmware, read battery date codes off the blocks, take baseline measurements and establish whether a working maintenance bypass exists. Where a manufacturer restricts certain work to its own authorised partners we will tell you.

What Australian standards apply to UPS maintenance?

AS/NZS 3000 governs the electrical installation around the UPS including supply, protection, isolation and the bypass arrangement. AS/NZS 4836 governs safe working on low voltage installations and determines which tasks require the unit isolated. The AS 62040 series, adopted from IEC 62040, covers uninterruptible power systems themselves, with AS 62040.1 for general and safety requirements and AS 62040.3 for performance and the VFD, VI and VFI topology classification. AS/NZS 5139 applies to lithium and battery energy storage installations. IEEE 1188 and IEEE 450 are the recommended practices for VRLA and vented battery maintenance. Where a UPS backs emergency or exit lighting, AS 2293 and AS 1851 impose their own testing regime.

Does a maintenance visit include battery replacement?

No. Replacement batteries are quoted separately rather than bundled into a visit price, so you are not paying an averaged premium against a replacement you may not need. What a visit does is tell you when replacement is coming, by trending impedance across visits so the end of life date is known ahead of time and lands in a budget rather than arriving as an emergency. Under a maintenance plan that forecast is the point of the arrangement. Battery scope, lead times and disposal are covered on our battery maintenance and replacement page.

Next step

Tell us the brand, the rating and roughly how old the batteries are, and we can tell you what a visit should cover and what it will cost.

If you do not know any of that, say so. On an inherited system the first job is an audit and we quote it as one. Call 1800 046 344, email sales@indigipc.com.au, or use the contact page. Indigi Power and Cooling is Indigenous and Veteran-owned, Supply Nation and ICN Gateway registered.

Book a service visit →
