Service  /  Critical Power Installation

Three Phase UPSInstallation and Commissioning Australia

Capacity10kVA to multi-MW
HubsBrisbane / Sydney / Melbourne
Installed from$3,200 ex GST
CertifiedAS/NZS 3000

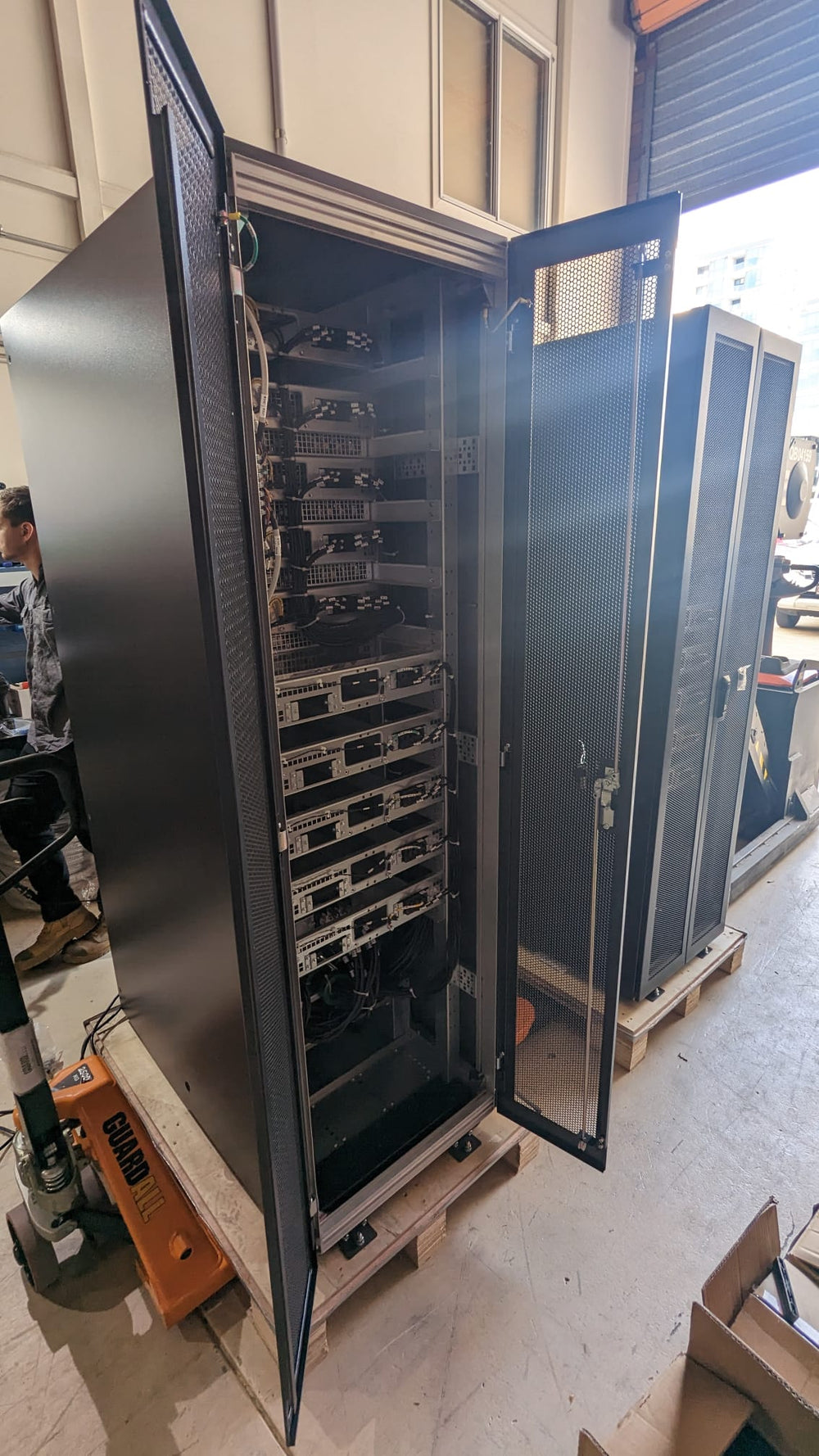

Vertiv Liebert EXM three phase UPS and battery cabinets installed in an Australian plant room

Switchboard / Bypass / Load bank

At this size the UPS is rarely the hard part. The switchboard works, the bypass strategy and the cutover plan are what decide whether the job goes smoothly.

Get an install quote

Direct answer

A three phase UPS installation is a switchboard project as much as an equipment project: it requires dedicated input and output submains, a wrap-around maintenance bypass so the system can be serviced without dropping the load, external battery cabinets, and load bank commissioning to prove capacity before the real load is transferred onto it.

Indigi Power and Cooling installs and commissions three phase UPS systems from 10kVA to multi-megawatt across Australia, certified under AS/NZS 3000, from $3,200 ex GST.

What actually takes the time

The UPS isthe easy part

Nobody books a three phase UPS install because they are worried about lifting the cabinet into place. The complexity lives upstream and downstream of it: whether the switchboard has the capacity and the physical space, how the load gets transferred without an outage, and how you prove the system works before you trust it with a data hall.

A typical three phase job involves a new input submain sized for the UPS and its battery charging current, an output submain to a dedicated critical distribution board, a maintenance bypass arrangement, earthing and fault loop verification, and battery cabinets that frequently weigh more than the UPS itself. Where a generator is involved, the interface and the transfer sequence need designing rather than assuming.

The other constraint is that these sites usually cannot go dark. Most of our three phase work is retrofit into a live environment, which means a staged cutover, temporary supplies or bypass work, and windows scheduled at times nobody enjoys working. That is planned at site inspection, not improvised on the day.

Indigi Power and Cooling is Indigenous and Veteran-owned, Supply Nation and ICN Gateway registered, which matters for government, defence and enterprise procurement. Our installers are licensed electrical workers and every system is commissioned with a signed record.

Configuration

Standaloneor redundant

Single module

Standalone

  • One UPS carrying the whole critical load
  • Lowest capital and installation cost
  • Maintenance bypass essential, not optional
  • Servicing means running on raw mains via bypass
  • Suits industrial plant, comms rooms, smaller halls
N+1 and beyond

Parallel
redundant

  • Two or more modules sharing the load
  • One module can fail or be serviced with no loss of protection
  • Parallel tie cabinet and matched cable lengths required
  • Commissioning includes load sharing verification
  • Standard for data halls, hospitals and Tier-rated facilities

Modular systems sit between the two. A single cabinet holds several hot-swappable power modules, so capacity can be added later and a failed module replaced without shutting the frame down. The Liebert EXM in the photograph above is this arrangement: individual power modules stacked in one frame, each removable while the system stays online.

The installation consequence is worth knowing before you specify. Modular frames are usually cheaper to expand and simpler to service, but the frame is sized at purchase, so the capacity ceiling is fixed on day one. Parallel systems cost more to install because of the tie cabinet and cable matching, but the ceiling is higher.

35
Typical days on site
N+1
Standard data hall redundancy
100%
Load bank tested before handover
AS 2676
Applies to battery installation

The part people skip

Maintenancebypass

If there is one thing worth insisting on at design stage, it is this. Without it, every future service visit means an outage.

A maintenance bypass, sometimes called a wrap-around bypass, is external switchgear that lets the load be fed directly from mains while the UPS is completely isolated. It is not the same as the internal static bypass, which keeps the UPS energised and cannot be used to work on the unit safely.

Sites without one face an unpleasant choice every time the UPS needs a battery change, a capacitor replacement or a firmware update: take an outage, or defer the work. Deferring the work is what people actually do, which is how UPS systems end up with five-year-old batteries and no one willing to test them.

Retrofitting a bypass later is possible but costs considerably more than installing one at the outset, because the switchboard work has to be done around a live load. If you are installing a three phase UPS now, put the bypass in now.

Maintenance bypass switches we install

Proving it works

Load bank commissioning

A three phase UPS should never meet its real load for the first time in production. A load bank applies a controlled artificial load so the system can be taken to full capacity, held there, and failed deliberately, before anything valuable depends on it.

Table: Three phase UPS commissioning tests and what each one proves
Test What it proves
Pre-energisation
Insulation resistance and continuity Cabling and terminations are sound before anything is energised
Phase rotation and earth fault loop impedance Supply is correct and protective devices will operate within required times
Battery string voltage, polarity and torque Strings are correctly assembled, and connections will not develop hot joints
Functional
Static and maintenance bypass transfer Load can be moved on and off the UPS without interruption, in both directions
Mains failure simulation The system carries the load on battery when the supply is removed, cleanly
Load sharing, parallel systems only Modules share load evenly and the system rides through a single module failure
Capacity
Load bank test at design load The system delivers rated output under sustained full load without alarming or derating
Battery autonomy discharge test Actual runtime at design load, which is the only number worth quoting to a board
Thermographic scan under load No developing hot joints in the switchboard or terminations at working current

Where a facility requires witnessed testing for a consultant, head contractor or Tier certification, we schedule and document accordingly. The output is a signed commissioning record with the measured results, not a tick sheet.

Commercial

Three phase installation pricing

Australian rates, ex GST, covering electrical installation and commissioning. Equipment, switchboard fabrication and load bank hire are quoted per project.

Small, to about 40kVA
$3,200
Ex GST / from

Switchboard connection, battery cabinets, maintenance bypass and full commissioning. Typical for comms rooms and smaller plant.

Medium, to about 200kVA
$6,500
Ex GST / from

Switchboard works, parallel or redundant configuration, load bank commissioning and battery autonomy testing. The typical data hall or hospital install.

Large and multi-module
Quoted
After site inspection

Design review, staged cutover planning, witnessed testing and commissioning documentation to consultant or Tier requirements.

The biggest cost variables are switchboard capacity, the length and route of the new submains, whether the existing load can be interrupted at all, and access for battery cabinets. We quote fixed price after inspection.

How it runs

From design review to handover

Site inspection and design review

Measured load and growth allowance, switchboard capacity and spare ways, submain routes, battery cabinet access and floor loading, room heat rejection, and any generator interface. Where a consultant has specified the system, we review the design against site reality before pricing.

Cutover method statement

How the load moves onto the new system without an outage, what temporary supplies or bypass arrangements are needed, which windows require out of hours work, and what the rollback is if something does not go to plan.

Switchboard and submain works

Input and output submains sized for load plus battery charging, protective device coordination, maintenance bypass installation, earthing and bonding, labelling and schedules updated.

Equipment installation

UPS frame and battery cabinets positioned with service clearances, parallel tie cabinet and matched cabling on redundant systems, battery strings assembled and torqued to specification.

Commissioning and load bank testing

The full test sequence above, including transfer testing in both directions, load bank testing at design load, battery autonomy discharge and thermographic scan under load. Witnessed where required.

Staged cutover and handover

Load transferred in planned stages, compliance certificate and signed commissioning record issued, as-installed drawings and schedules updated, operator training delivered and a maintenance schedule handed over.

Three phase UPS maintenance

Where they go

Facilities we install into

Trusted by

Royal Australian Navy
Queensland Government
NSW Government
QBuild Queensland Public Works
Visy
Daltron
IVF Australia
ELA Group
RA Marine Services
MedDent Brian Bell

Questions

Three phaseinstall FAQs

What consultants and facilities teams ask before a three phase install. If yours is not here, call 1800 046 344.

What is a three phase UPS?

A three phase UPS takes a three phase supply, typically 400V between phases in Australia, and is used where the critical load is too large for a single phase system or where the building supply is already three phase. Capacities start around 10kVA and run into multiple megawatts. Some units accept three phase input and deliver single phase output, which is a common arrangement in the 10 to 40kVA band.

How much does three phase UPS installation cost in Australia?

Indigi Power and Cooling installs three phase UPS systems from $3,200 ex GST for smaller systems up to about 40kVA, and from $6,500 ex GST for medium capacity to around 200kVA. Larger and multi-module systems are quoted after a site inspection. Those figures cover the electrical installation and commissioning; equipment, switchboard fabrication and load bank hire are quoted per project. The main cost variables are switchboard capacity, submain length and whether the existing load can be interrupted.

Do I need a maintenance bypass?

For any three phase UPS, effectively yes. A maintenance bypass is external switchgear that feeds the load directly from mains while the UPS is fully isolated, so the system can be serviced without an outage. It is not the same as the internal static bypass, which keeps the UPS energised and cannot be used to work on the unit safely. Retrofitting one later costs substantially more, because the switchboard work has to be done around a live load.

What is UPS load bank testing?

Load bank testing applies a controlled artificial load to the UPS so the system can be run at full rated capacity without connecting the real load. It proves the system delivers rated output under sustained load without alarming or derating, and it allows a battery autonomy discharge test that measures actual runtime at design load. It is the difference between believing a UPS will carry the facility and knowing it will.

How long does a three phase UPS installation take?

Three to five days on site is typical, extending where switchboard modification, a new submain or a staged cutover is required. The equipment placement is rarely the constraint. Switchboard works, cable routes and the number of interruption windows the site can tolerate are what set the programme, which is why the cutover method is agreed at inspection rather than on the day.

What is the difference between N+1 and a modular UPS?

N+1 parallel redundancy means two or more complete UPS modules share the load through a tie cabinet, so any one can fail or be serviced with no loss of protection. A modular UPS holds several hot-swappable power modules inside one frame, giving similar resilience with simpler installation, but the frame fixes the capacity ceiling at purchase. Parallel systems cost more to install because of the tie cabinet and matched cabling, and are used where the ceiling needs to be higher.

Can a three phase UPS be installed without downtime?

In most cases, with planning. Where a maintenance bypass exists the load can be transferred onto it and the work done live. On retrofits without one, we install temporary supplies or a temporary bypass and stage the cutover, scheduling the brief transfer windows out of hours. The method statement, including a rollback plan, is agreed before work starts.

Equipment

Three phasebrands we install

We install and commission the platforms we also service, so the technician commissioning your system is the one who will maintain it. Equipment specified by a consultant or bought elsewhere is no problem: we will quote the installation on its own.

Vertiv Liebert
EXM modularEXS 10 to 80kVAAPM and TrinergyPowerUPS 6000 industrial
View range
Eaton
93PS93PM modular9395 large frameIndustrial and marine UPS
View range
Schneider APC
Galaxy VSGalaxy VL and VXSymmetra modular
View range
Socomec
Modulys modularDelphys large frameIndustrial and process UPS
View range
PowerShield
Centurion Pro three phaseAustralian designed and supportedDefence and government supply
View range
Switchgear
Maintenance bypass switchesAutomatic transfer switchesExternal battery cabinets
View range

Replacing an end-of-life three phase system? We handle staged cutover, temporary supplies and disposal of the old unit and its battery strings. Send us the existing make, model and single line diagram and we will quote the replacement including the method statement.
